How long does an exporter need to produce verified CBAM emissions data?

Questions › Category: CBAM › How long does an exporter need to produce verified CBAM emissions data?
1 Answers
Best Answer
Team GreenSutra Staff answered 2 months ago
Time needed for verified CBAM data: a long track across a plain marked by evenly spaced posts

Verified CBAM data cannot be produced faster than the calendar allows, because it requires a completed monitoring year followed by site verification. Imports made during 2026 are declared by 30 September 2027 under the definitive regime, and CBAM certificates go on sale from 1 February 2027.

The common assumption is that verified data is a document that can be commissioned and delivered in weeks. It is not. Verification tests a period, and a period cannot be tested before it has closed.

The fixed dates

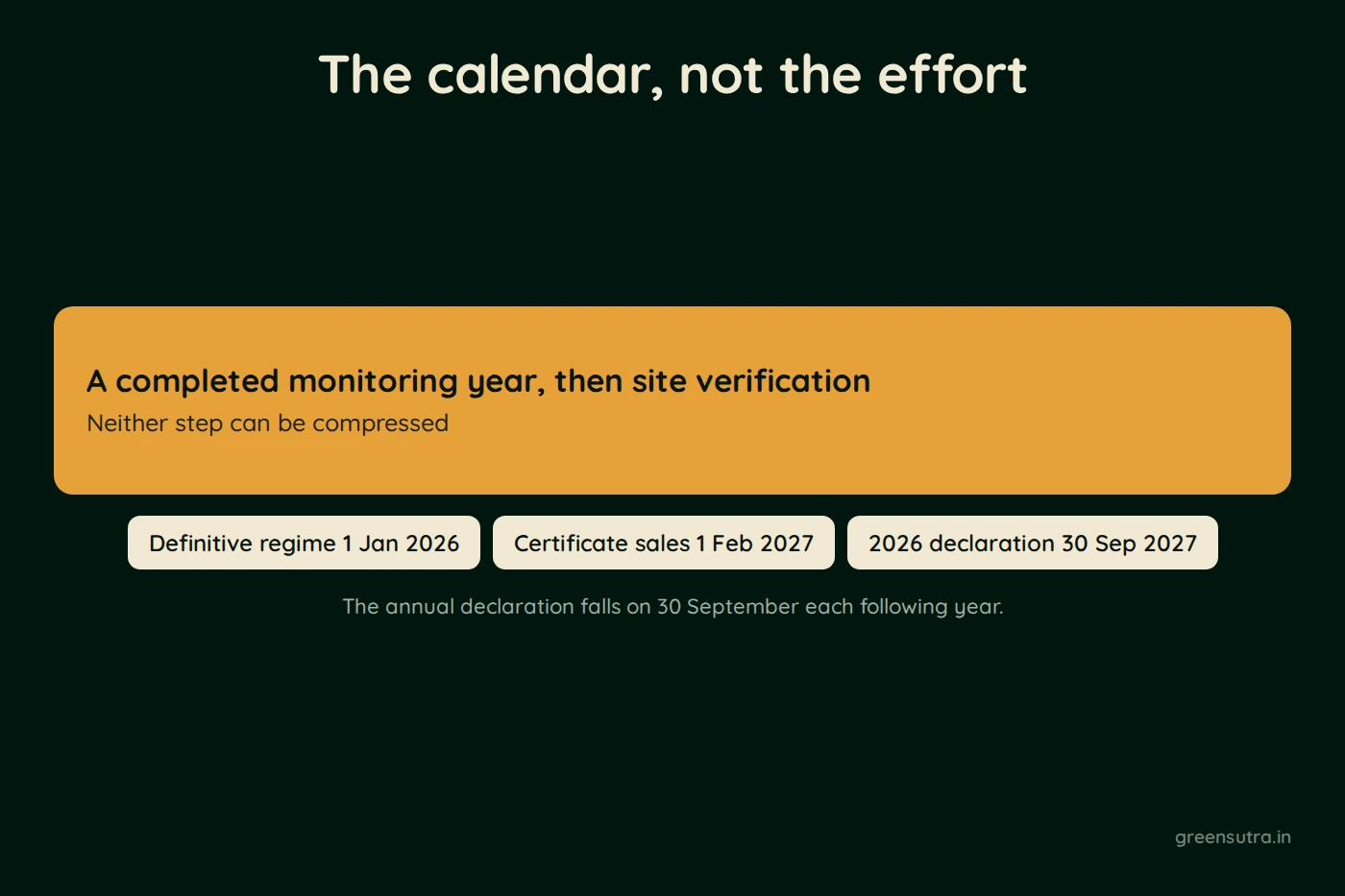

Diagram, The calendar, not the effort. A completed monitoring year, then site verification (Neither step can be compressed). Definitive regime 1 Jan 2026, Certificate sales 1 Feb 2027, 2026 declaration 30 Sep 2027
The calendar, not the effort
Milestone Date
Definitive regime begins 1 January 2026
CBAM certificate sales open 1 February 2027
Annual declaration for 2026 imports due 30 September 2027
Annual declaration thereafter 30 September each following year

Why the sequence sets the floor

Three steps run in order and none can be compressed away. First, a monitoring methodology has to be documented before the period it governs begins, because a verifier tests whether the stated method was the method actually applied. Second, the monitoring year has to run to completion, producing activity data, fuel and material inputs, electricity consumption and precursor records across the whole period. Third, verification takes place after the period closes and involves examination at the installation.

An installation that begins documenting its methodology in the middle of a year has not shortened the timeline. It has forfeited that year.

What happens in the meantime

An importer can declare actual data or country-of-origin default values, and the defaults carry a mark-up which rises through the phase-in. That mark-up is the mechanism that makes verified actual data progressively cheaper than the alternative rather than a penalty as such, and it is why the timeline question is really a cost question.

A complex good can combine actual emissions for the installation’s own processes with default values for one or more precursors, under Article 15 of Implementing Regulation (EU) 2025/2547. That gives some room where one precursor supplier in a long chain cannot report.

Sources: Regulation (EU) 2023/956, Regulation (EU) 2025/2083

Starting the monitoring documentation before a period opens is the only lever that shortens the path. CBAM solutions covers monitoring methodology and data collection design, and the CBAM guide sets out the annual cycle those dates sit inside.
